William A. and Ami Kuan Danoff Life Sciences Laboratories - Construction Information

Construction Closure Information & Construction Updates

Construction Closure Overview

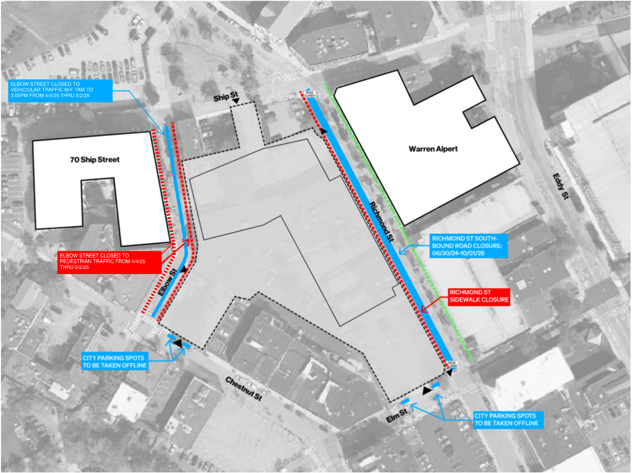

June 2024 – February 2027

  • Richmond Street southbound lane closure
  • Richmond Street southbound sidewalk closure
  • Northbound sidewalk remains open
  • Elbow Street northbound sidewalk closure
  • Chestnut Street parking spots to be taken offline
  • Elm Street parking spots to be taken offline

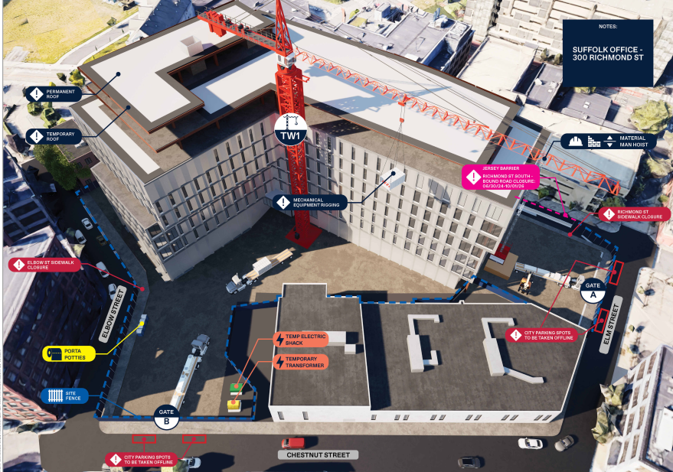

Aerial map of Danoff construction site


Construction Updates

Please note, scope may change based on existing conditions found in the field.

November - December 2026

Week of November 23, 2026

  • Site Closed Thursday 11/26 for Thanksgiving
  • Fire Alarm Programing and Testing
  • Balancing
  • Start-Up and Commissioning of Equipment
  • Install Control Wiring Level 8
  • Tel-Data / Security Level 8
  • Doors and Frame Install Level 7
  • Casework Install Level 7
  • MEP Finishes Level 7
  • Finish Hub and Bathroom Level 6
  • Complete Bathrooms Level 5
  • Complete Hub Ceiling Level 5
  • Polished Concrete Level 1
  • Millwork Install Level 1
  • Casework Level 1
  • Lights Level 1
  • Landscape along Elm St
  • Granite Seawall and Bench Install

Week of November 30, 2026

  • Fire Alarm Programing and Testing
  • Balancing
  • Start-Up and Commissioning of Equipment
  • Install Control Wiring Level 8
  • Tel-Data / Security Level 8
  • Doors and Frame Install Level 7
  • Casework Install Level 7
  • MEP Finishes Level 7
  • Rough Clean Level 6
  • Complete Bathrooms Level 6
  • Complete Hub Millwork Level 5 and 6
  • Millwork Install Level 1
  • Casework Level 1
  • Landscape along Elm St
  • Granite Seawall and Bench Install

Week of December 7, 2026

  • Fire Alarm Programing and Testing
  • Balancing
  • Start-Up and Commissioning of Equipment
  • Install Control Wiring Level 8
  • Tel-Data / Security Level 8
  • Doors and Frame Install Level 7
  • Casework Install Level 7
  • MEP Finishes Level 7
  • Punchlist Level 6
  • Millwork Install Level 1
  • Casework Level 1
  • MEP Finishes Level 1
  • Lights Level 1
  • Wood Ceiling Level 1
  • Hardscape Install South Link
  • Granite Seawall and Bench Install
